2015 ~ Present Hong Kong
Central – Wan Chai Bypass Diaphragm Wall & Flyover Demolition
This project is to remove 53,000 m3 127,300 tons R.C. diaphragm wall included D-wall underwater and 1500 m long flyover at Island East Corridor
The demolition process can be separated into 3 parts:
Part 1 - Remove RC Breakthrough
Volume: 6,800m3 / 16,400 tons
within 40 working days
Site Location :

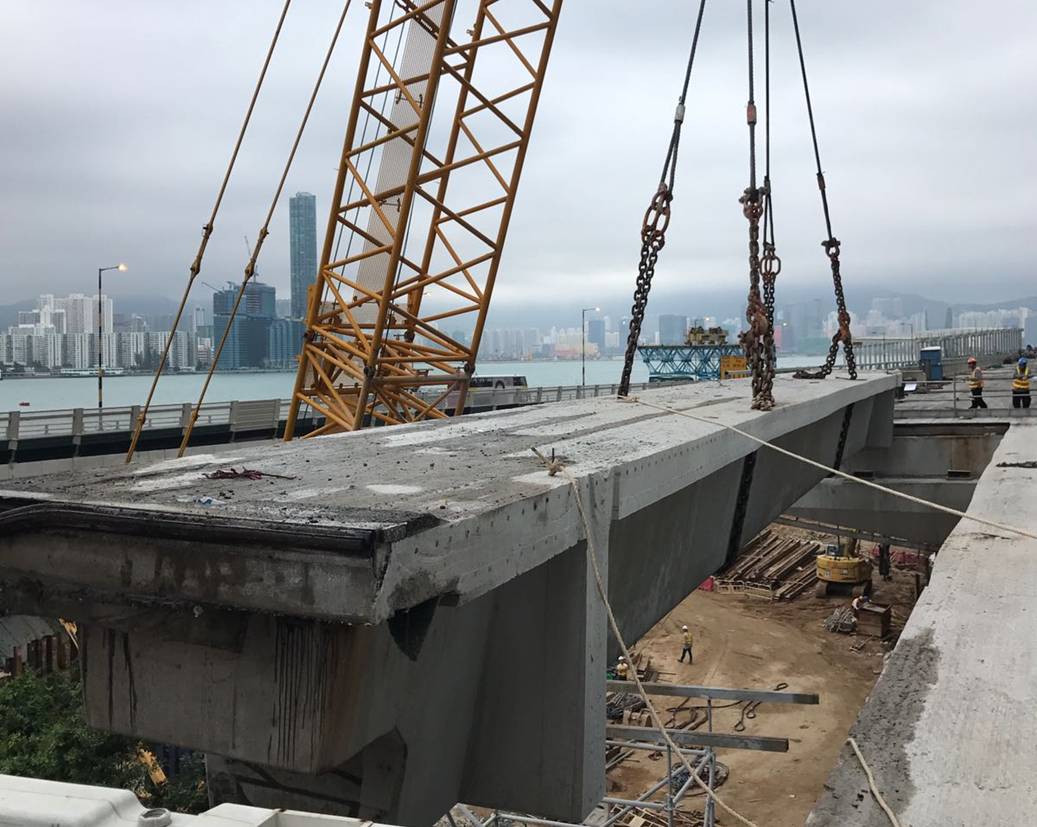

Part 2 - Remove Flyover
Length:
Approx. 1500m
Volume: 25,200 m3 / 60,500 tons
within 240 working days

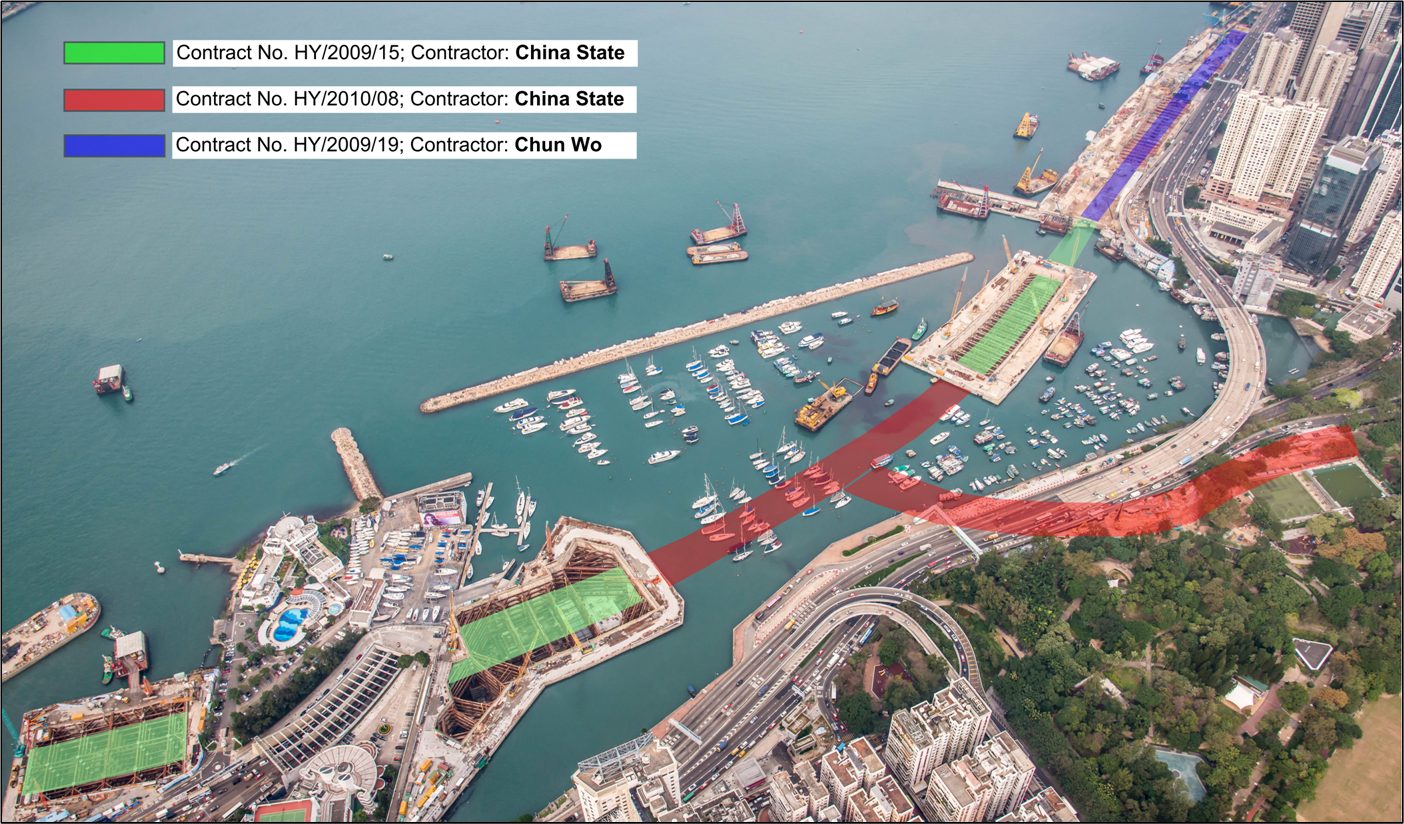

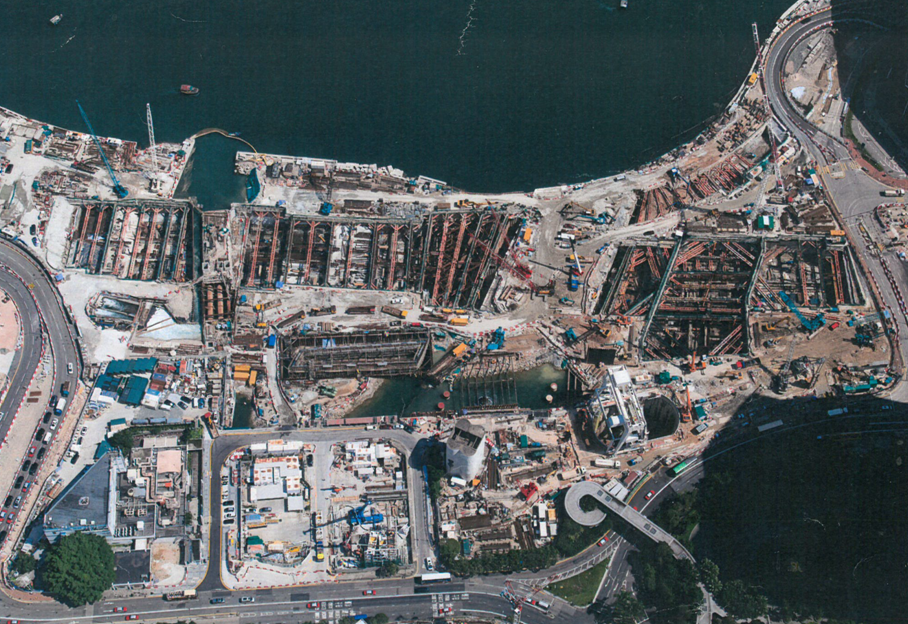

Site Location:
Part 3 - Remove D-wall Underwater
Length:
Approx. 1400m
Volume: 21,000m3 / 50,400 tons
Site Work (Part 3):
Site Work (Part 1)
Site Work (Part 2)
